Q Bank for Civil Engineer LDCE Exam - WORKS

 Q 1: - What precautions should be taken while collecting water samples from tap for Bacteriological testing?

Answer: - The precautions to be observed while taking water samples for bacteriological test from a tap are as under. Only sterilized bottles with lid should be used. The paper cover from the sterilized bottle should be removed just before taking samples. The stopper/lid should be removed just before filling the bottle. The stopper/lid should be held from the top while the bottle is being filled. Contamination while filling the bottle must be avoided. The mouth of the tap from which the sample is taken should be heated by a spirit lamp for three minutes. Water shall than be allowed to flow freely for 5 minutes before sampling. Bottles containing samples of water should be properly labeled, packed around with Ice and saw dust and sent without any delay to reach the DMO for examination.

Q 2: - List out the division of responsibilities for prevention / reporting among the various staff in regard to new Encroachment.

Answer: - 1. Within station premises: Lies with the Station master jointly with concerned RPF inspector and senior most RPF official at that station where no RPF inspector is posted.

2. Within / around the colony premises : Lies with the concerned Section Engineer works jointly with concerned RPF inspector and senior most RPF official at that station where no RPF inspector is posted.
3. In between stations: Lies jointly with concerned Section Engineer works/ P.way and RPF official.

4.In Loco sheds: Lies jointly with the nominated section Engineer of the loco shed and RPF Inspector.

5. In carriage & Wagon depots: Lies jointly with nominated section Engineer of the depot and RPF official. 6 In workshops: Lies jointly with nominated section Engineer (of the department to which the workshop belongs) of the Workshops and RPF official.

Q.No.3 (A) Describe minimum passenger amenities for deferent classes of railway stations including adarsh, model and modern stations. Minimum essential amenities. Availability of these amenities at the prescribed scale will have to be ensured.

MINIMUM ESSENTIAL AMENITIES AT EACH CATEGORY OF STATIONS.

1. External painting of high rise building involves more effort, time and risk due to requirement  of high scaffolding and other temporary arrangement. It is there for desirable that the exterior  painting  in   these  building  should  last   more  than  5  years  without  losing  sheen.  Exterior  wall   paint  should  be  resistant  to  algae,  fungus,  moss  growth,  ultraviolet  rays,  etc.  it  should  be   capable to fill up micro cracks on wall surface and should not allow dust/ pollutant s to adhere  to its surface.

2. Contrary to this , useful life of waterproofing cement paints is very less. These paints lose their  sheen and look shabby in a short period of time and often require painting every year/ alternate  year depending upon climatic conditions, dust and pollution etc.

3. In case exterior wall painting of old high rise buildings (G+4 & above), the old paint should be  removed completely by scraping . Plastered surface may need repair/ re-plastering .  Depending upon the surface condition. Leakage, dampness, etc. has to be completely  attended.  If  needed,  thin  layer  of  white  cement  based  putty  can  be  applied  on  the  plastered   surface  to  fill  mirror  cracks/  crevices  in  the  wall  surface  and  reduce  seepage  &  surface   irregularities. These activities can be done under relevant items of Northern Railway  USSOR/Non  schedule  items.  Subsequently,  painting  can  be  done  with  premium  acrylic   smooth exterior paint with silicon additives as per NR-USSOR Item No. 115180.

4.  It is important that to get better quality, paints from very reputed brands only should be used.  For  guidance,  some  of  the  reputed  brand  names  are  dulux,  Asian  brochures,  regarding   application methodology, should be followed for getting desired performance.

5.  Such “premium Acrylic smooth exterior paints with silicon additives” are expected to last in  serviceable condition for about 5 years, if painted after proper surface preparation. In case, re-  painting  before 5 years is required o condition basis, Pr. Chief Engineer’s prior approval  should be obtained. 6.  In case of buildings having floors less thanG+4, but otherwise important in \character, such  exterior      wall painting , if required, can be done, with the approval of DRM.

Q.No.3(d) Explain works certificate to be issued to artisan’s staff to be deployed by  contractors on  works site by respective ADENs. Before the artisans are allowed on the job at site, the ASEN concerned shall examine their  training certificate and or works experience certificate mentioned artisan staff on a particular  railway work. Any artisan without “permit to work certificate” by the ADE in charge of the work shall not be  deployed at the work site. “The contractor shall place and keep on the works at all times efficient and competent staff to  give the necessary directions to his workmen and to see that they supervisors, workmen and  labourers in or about the execution of any of these works as are careful and skilled in the various  trades”. Due to lack of emphasis on deployment of adequately skilled staff, the quality and workmanship  of works suffer so also the life of assets. As such for all the contracts under execution or to be  awarded in future, it should be ensured that any artisan deployed by the contractor/out sourced  agency, shall have any of the following skills certificate and or experience certificate:

i. Minimum three years of experience of having worked satisfactory for similar skill trade  at any important site with reputed contractor / outsourced agency.

ii. Certificate of excellence by railway officer(minimum ADEN level).

iii. Certificate of training in particular trade for ITI or National Skilled Development  Corporation (NSDC) or any similar recognized Institution for training in that particular trade. The above experience/ skills certificate criteria shall be applicable for all artisans like mason(of  concerned skill e.g. mason skilled for brick work and mason skilled for tilling work are different  sills), fitter, blacksmith, painter (of concerned skill). Whitewasher, carpenter, receptionist/  supervisor/housekeeping staff etc.

Question.4:  What are the various planning aspects for planning Railway Staff Colonies?
Answer:-  For Planning of railway staff colonies, following factors should be considered.

a) Orientation of buildings:-  The Chief aim of orientation of buildings is to provide  physically and psychologically comfortable living inside the building by creating  conditions which suitably and successfully ward off undersirable effects of severe weather  to the best possible extent.   Prevailing Winds and relative humidity

b) In the coastal areas, because of less diurnal variation of temperatures along with high  humidity, the emphasis should be on prevailing winds.   The best orientation from solar point of view requires that the building as a whole should  receive the maximum solar radiation in winter and the minimum in summer.

c) Water  supply,  drainage  and  sewerage  system:-    Adequate  water  supply  and  sullage  and   storm  water  drains  should  be  provided.    The  water  supply  system  should  be  designed  on   the basis of at least 200 litres/person/day (which includes 45 litres for flushing  requirements)  due  allowance  being  made  for  gardens.      Where  common  hydrants  are   provided,  these  may  be  equipped  with  suitable  anti-waste  water  taps.    For  multi-stories  builds, necessary static tanks may be provided for fire fighting arrangement in accordance  with the regulations laid down.   Where water borne sewerage/exists in the vicinity, open drains and soak-pits should be  dispensed with and an adequate underground system provided. For colonies provided with  adequate piped water supply with overhead storage facilities and where no sewerage  system exists in  the vicinity, an under ground sewerage system with one or two septic  tanks according to the layout of the ground should be provided.   Guidelines for the selection of an appropriate sanitation system are given.   Groups of latrines or urinals should not be located within 15 meters of living quarters, 30  meters of any cook house or food stall, 45 meters of any well supplying drinking water and  should be located away from public buildings adjoining  railway colonies.

d) DUSTBINS:-  These should be conveniently located with respect to the quarters and  regularly cleared by the conservancy staff.  In the case of multi storied buildings garbage  chutes may be provided with opening in each floor with arrangements for closing the  openings.

e) SHADY TREES:- Shady trees like Gulmohur, Neem should be provided along service  roads at close intervals.  Such trees should be provided along the periphery of parking  areas and in the circulating areas in railway stations.  Some ornamental trees like Alstonia,  Kachnar, Bottlebrush, Cassia, Silver Oak, Mulsari,   Plumerica, Ashoka and shrubs like, Chandani, Gardinia, Chinese Orange and Jatruca may  also be plated.  For beautification of circulating areas of stations, service of the Guardens  may be maintained in circulating areas through voluntary agencies or business houses on
terms and conditions to safeguard the interest and rights of the railways.

f) PLAY GROUNDS FOR CHILDRENS:-  An open space at an appropriate place in the  colony may be left for entertainment and  sports of the employees and their wards.

Question.5.:  What is controlled concrete?  Differentiate it from ordinary concrete.  Generally what type  of concrete mix are used for various structures.

Answer:-  Types of Concrete:-

Ordinary concrete:  The concrete, in which no preliminary test are performed for designing the  mix, is called ordinary concrete.   Controlled concrete: The concrete, in which preliminary tests are performed for  designing i.e. the mix, is  called controlled concrete.  The controlled concrete described as  M10,M15,M20,M30,M35  &  M40  etc.  depending  upon  characteristic  strength  of   concrete.  General Concrete Mix for Various Purposes.

Q.6.  Define  Earnest  Money,  Security  Deposit  and  performance  Guarantee.  In  which  form   Earnest Money Deposit, Security Deposit and Performance Guarantee should be  submitted. Ans. EARNEST MONEY: Earnest Money is the amount asked from the participating tenderer  in  token  of  the  genuine  interest  in  the  work  on  the  part  of  the  tenderer.    On  acceptance  of  the   offer, total EMD becomes part of the security deposit for the performance of the contract.  The  Earnest Money Deposit(EMD) of unsuccessful tenderer is returned  immediately on finalization  of the tender.  In case of withdrawn of the offer after opening of the tender but before finalization  of  the  tender  within  validity  period,    EMD  is  forfeited.    The  cost  of  work,  on  which  EMD  is   calculated  should  be  realistically  assessed  considering  the  prevalent  market  rates.    The  scale  of   EMD is given below:

Value Of The Work                                Earnest Money Deposit (EMD)

A.  For works estimated to cost            2% of the estimated cost of the work upto Rs.1 Crore

B.  For works estimated to cost        Rs.2 lakh plus ½% (half percent) of the more than Rs.1 Crore    'excess of the estimated cost of work  Beyond Rs.1 Crore subject to a  maximum of Rs.1 Crore '

The earnest money shall be rounded to the nearest Rs.10.

SECURITY DEPOSIT:  It is the amount to be deposited by the successful tenderer as a token  of the guarantee for the due and faithful fulfillment of a contract.  The scale of Security Deposit  is as given below:

Q.8. Describe the procedure for construction of houses for public sector undertaking under  Ministry of Railway. Ans.  Following conditions for const. of houses for public sector undertaking under ministry of  Railways to be considered. There is general shortage of houses for officers and it has been decided that Railway PSUs may  be allowed to construct houses on Railway land to overcome the shortage of houses on terms and  conditions as mentioned below:-

i) Of  the  total  number  of  flats  constructed  by  Railway  PSU,  50%  will  be  for  use  by  the   Railway  Administration  and  the  remaining  50%  will  be  licensed  to  the  Railway  PSU  at   normal license fee of Rs. 1000/- per annum per house, which may be paid annually.

ii) The  Railway  PSU  concerned  will  bear  full  cost  of  construction  on  Railway  land.  The   developments of surroundings and provision of services like road, water/electric  connections,  telecom  and  drainage  and  lifts  etc.  would  also  be  provided  by  the  PSU   constructing the quarters.

iii)  Ownership  of  the  land  and  structure  thereon  will  continue  to  be  with  the  railways  ad   Railway will only license out 50% houses to the PSU. PSU at no stage will sell/Sublet for  transfer these flats or any of the services to any other individual/authority.

iv)  Maintenance  of  the  flats  licensed  to  the  PSU  will  be  done  by  the  concerned  PSU.  It   should  be  ensured  that  proper  maintenance  to  be  done  by  PSUs  so  that  at  the  time  of   handing  over  these  houses  to  the  Railways,  they  are  in  safe  condition  as  at  the  time  of   aging over except the natural aging. All the taxes payable on these flats to the concerned  civil  authority  will  also  be  paid  by  PSU.  The  electric  and  water  charges  should  be   recovered as per rules from the officers of PSUs and remitted to Railways.

v)  No structural change whatsoever will be  made by the PSUs in the flats.

vi)  These flats will be licensed for a period of 30 years from the date of handing over of the  flats to the PSU or till such time it exists or remains attached to the Ministry of Railways,  whichever date falls  earlier. After this period, the flats allotted to the PSU will be taken  over by the Railways without any compensation/payment whatsoever to the PSU.

vii) Railway  will  have  unrestricted  and  unconditional  authority  to  enter  the  premises  by  its
authorized  representative  for  inspection  or  for  safety  of  for  any  other  purpose  as  and   when required.

viii) These  houses  will  be  allotted  only  to  railway  officers  on  dep8tatiojn  ot  the  concerned PSUs or who have come on absorption.  The allotment and retention of these  houses will be governed by the Railway rules and consultants/Advisers to PSUs will not  be eligible.

Q.9.  What  are  the  various  planning  aspects  for  planning  New  Railway  colonies  in  Metro  cities. Ans. For Planning of railway staff colonies, following factors should be considered :

i) Orientation  of  buildings  :-  The  chief  aim  of  orientation  of  buildings  is  to  provide   physically  and  psychologically  comfortable  living  inside  the  building  by  creating   conditions  which  suitably  and  successfully  ward  off  undesirable  effects  of  severe  weather to the best possible extent.

ii) Prevailing Winds and Relative humidity In the coastal areas, because of less diurnal variation of temperatures along with high  humidity, the emphasis should be on prevailing winds. In other areas, the emphasis should be on protection from solar radiation. The  best  orientation  from  solar  point  of  view  requires  that  the  building  as  a  whole   should receive the maximum solar radiation in winter and the minimum in summer.

iii) Water  supply,  drainage  and  sewerage  system  :-  Adequate  water  supply  and  sullage   and  storm  water  drains  should  be  provided.  The  water  supply  system  should  be   designed  on  the  basis  of  at  least  200  litres/person/day(which  includes  45  litres  for   flushing requirement) due allowance being made for gardens. Where common  hydrants are provided, these may be equipped with suitable anti-waste water taps. For  multi-stories buildings, necessary static tanks may be provided for firefighting  arrangements in accordance with the regulations laid down. Where  water  borne  sewerage/exists  in  the  vicinity,  open  drains  and  soak-pits  should   be  dispensed  with  and  an  adequate  underground  system  provided.  For  colonies   provided with adequate piped water supply with overhead storage facilities and where  on sewerage system exists in the vicinity, an underground sewerage system with one  or two septic tanks according to the layout of the ground should be provided. Guidelines for the selection of an appropriate sanitation system are given. Groups of latrines or urinals should not be located within 15 meters of living quarters,  30 meters of any cook house or food stall, 45 meters of any well supplying drinking  water and should be located away from public buildings adjoining railway colonies.

iv) DUST BINS:  These should be conveniently located with respect to the quarters and  regularly  cleared  by  the  conservancy  staff.    In  the  case  of  multi  stories  buildings   garbage  chutes  may  be  provided  with  opening  in  each  floor  with  arrangements  for   closing the openings.

v) SHADY  TREES:    Shady  trees  like  Gulmohur,  Neem  should  be  provided  along   service roads at close intervals.  Such trees should be provided along the periphery of  parking  areas  in  railway  stations.    Some  ornamental  trees  like  Alstonia,  Kachnar,   Bottlebrush, Cassia, Silver Oak, Mulsari, Plumeria, Ashoka and shrubs like Chandani,  Gardinia,  Chinese  Orange  and  Jatruca  may  also  abe  planted.    For  beautification  of   circulating areas of stations, service of the Gardens may be maintained in circulating  areas  through  voluntary  agencies  or  business  houses  on  terms  and  conditions  to   safeguard the interest and rights of the railways.

vi) PLAY GROUNDS FOR CHILDREN:  An open space at an appropriate place in the  colony may be left for entertainment and sports of the employees and their wards.

Q.10(a). What is the main cause  of damaging the sunshades in old building? What  precautions to be taken for providing RCC sunshades in new building construction?

(b)   What is main cause of roof leakage and what are the remedial measures in old flat roofs.

( c)  What precautions to be taken when construction of new buildings, that the roof leakage  problem may not arise?

(c )  Explain water cement ratio,  How  the water cement ratio effects the strength of concrete.

(d)  Explain, design mix concrete and nominal concrete etc.

(a) What are the main causes of damaging of sunshades in old buildings. What precautions to be  taken for providing RCC sunshades in new building construction. Ans. Mostly it is seen that the sunshades of old building starts damaged after few years of  construction. The followings are the main cause.

I. The top surface of sunshade having not proper slope due to which the rain water  stagnating on the top surface.

II. Lack of compaction of sunshade during casting.

III. Binding of reinforcement in wrong position or-mis-placing of reinforcement during  casting. The precautions to be taken while casting a sunshade in new building.

I. The shuttering of sunshade to be done more causiorsly and totally leak proof. The  compaction of sunshade to be done with shutter vibration, because due to less thickness of  concrete, the needle vibrator is not fruitful to compact the concrete.

II. The reinforcement (main) to be placed on top surface and ensured during casting that it will  not misplaced.

III. The top surface to finished sloppy as the water cannot stagnate on surface.

(b)Main cause of roof leakage.

I. Poor slope of top surface of roof.

II. Damaging and erosion of top surface treatment.

III. Badly provided khuras.

IV. Badly provided CC bata.

V. Leakage from sewer and drainage pipe and traps laid in roof.

Precautions to be taken while construction of new building.

I. The shuttering of roof to be done having camber as per specification, so that during casting of slab the depression in roof may not arise. A slight depression in top surface of roof is very  harmful although.

II. The casting of khura to be done cautiously with zero tolerance and the rain water to be fixed  properly.

III. The CC bata to be done prior to parapet plaster and as per specification.

IV. Minimum 1:4 slpe to be provided in top surface of roof treatment.

V. The over head tanks (if required to be placed on roof) to be placed on proper plate  form and  nearly to khura.

(c)Water cement ration:- The ratio  of the weight of water, to weight of cement used in a concrete mix is termed as water cement ration. As a results of experiments, it is observed that for  a given proportion of ingredients in a concrete mix, there is almost a fixed amount of water  (optimum) which gives maximum strength. A  small variation in qty of water causes much wider  variation in the strength of concrete. When the water comes. With contract  of cement particle, and react with cement particle some roofs are generated from  the cement particle. These roofs are binding the particle of ingredient of concrete. If we mix less  water from optimum Qty. of water, the all roots can not generate and the concrete will not gain  proper strength, but if we add more water than optimum requirement, the roots become diluted  and the grip of these roof become less, resulting to this the lesser strength concrete obtained.

(d)Nominal mix concrete Nominal mix concrete is used in works where the quality control requirements for designed  mixes are difficult to be implemented. The nominal mix concrete can be produced by taking  cement, fine aggregate and coarse aggregate in the ration of 1:n:2n for normal work. However,  the ration of coarse aggregate to fine aggregate  can vary from 1 ½: 1 to 2 1/2 :1 in situations  where denser or more workable concrete is to be produced.  Mix design concrete:- the aim of mix design is to determine the proportion in which, cement,  fine sand, coarse aggregate and water should be mixed to produce concrete of required strength,  workability and durability with minimum cost. When the task of deciding the proportion of the  constituents of concrete is accomplished by use of certain established relationship (which are based on inferences drawn from large number of experiments) the concrete these produced is  termed as design mix concrete.

Q.11(a) What are the pre fab buildings? Describe in details, what is advantage and              disadvantage of these buildings?

(b)  What are new building materials generally available in markets and what  are the advantages  over conventional building materials?    (a)
Prefabricated homes, often referred to as prefab homes or simply prefabs,  are specialist dwelling types of prefabricated building, which are manufactured  off-site in advance, usually in standard sections that can be easily shipped and  assembled. Some current prefab home designs include architectural details
inspired by postmodernism or futurist architecture   Advantages  The advantages of using prefabrication in housing are that:

• prefabricated components speed up construction time, resulting in lower labour costs;
• prefabrication allows for year-round construction;
• work is not affected by weather delays (related to excessive cold, heat, rain, snow, etc.);
• the mechanization used in prefabricated construction ensures precise conformity to building code standards and greater quality assurance;
• there are less wasted materials than in site-built construction;
• there is less theft of material/equipment (and less property damage due to vandalism);
• materials are protected from exposure to the elements during construction;
• worker safety and comfort level are higher than in site-built construction;
• computerization of the production process permits a high degree of customization, at an affordable cost;
• quality control and factory sealing and design can ensure high energy   efficiency; and
• cost savings through prefabrication can reduce the income required to qualify for a high ratio mortgage by up to one third compared to a  conventionally built home of the same size.

DISADVANTAGES
The issues related to using prefabrication in housing are that:
• many municipalities zone against manufactured housing because of earlier  perceptions created by trailer parks;
• concerns have been raised by local and regional governments with regard to whether the taxation paid by manufactured homes is sufficient to offset public costs such as schools;
• the requirement to transport manufactured homes or modules to their intended site can mean that prefabrication potential may be limited for infill projects in inner city areas; and
• Increased production volume is required to ensure affordability through  prefabrication.

(b) New Bldg. material: - The various new bldg material generally available in the market as

1. Sand lime/calcium silicate bricks.
2. Fly ash lime bricks.
3. Clay fly brick fly
4. Burnt clay flooring tiles.
5. Burnt clay flat terracing tiles.
6. fibrous gypsum plaster board.
7. Precast channel unit for floors/roof 8. Pre cast RC plancks & joints
9. Thin RC ribbed slab for floors & roofs.
10. Pre cast waffle unit for floor/roof.
11. Pre cast reinforced concrete panels for roofs.
12. Pre cast doubly  curved shell unit for floor/roof.
13. Prefabricated brick panels for floor/roof
14. Pre cast solid cement  concrete block
15. Precast concrete stone masonry block
16. Hallow & solid light for concrete block
17. RCC door & window frame
18. Ferro cement  doors shutters
19. Ferro cement  write tender 250-1000
20. Concrete man hole cover & frame
21. Flyash/ red mud polymer door shutter
22. Rubber wood flush door shutter.
23. Finger jointing  & shaping technology
24. Micro concrete roofing tiles.
25. Ferro cement  roofing channels
26. Glass fibre reinforce polymer door & door frame
27. Bamboo mat corrugated  roofing sheet
28. Bamboo mat ridge cap
29. Two storey bamboo housing system
30. Pre-fab double wall composite house.

Advantages of new material over conventional  material

1. New bldg. material are cost effective, environment- friendly & energy efficient.

2. These  new material technology are based on agro-indistrial waste such flymesh boord  bricks/block, cellnar light weight concrete, bamboo board material, bag are bond.

3. Conventional bldg. technology  burnt bricks, steel, & cement utilize size large amount of  non-renewable  like energy, miniral  top soil, forest cover etc. these are      dependence on  external natural and manpower, harm the locol energy & are generally  polluting in  nature.

4. New bldg. material are not danger  to bio-reserve  & are Non- polluting

5. There are self sustaining  & promote self reliance 6. Uses locally available material.

7. Law in monetary  cost

8. Utilize reasonable energy

Q.12(a).  What is chlorination and what is the function of chlorination.  Why the              super chlorination is required in a water supply network?

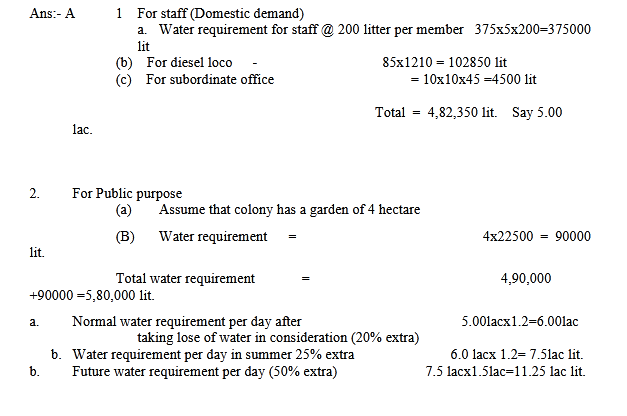

(b)  Give a reasonable estimate of daily consumption of 700 four storied colony having all  desirable amenities and design the water supply network  accordingly.

(a) What is chlorination and what is the function of chlorination. Chlorination:- Disinfection of water is necessary to kill pathogenic bacteria of water-born  diseases to make it safe for human. Consumption where the contamination of water is suspected,  water has to be sterilized to remove the bacterias which may dangerous. There is every chance of  water being contaminated during distribution, especially, and generally adopted in an  intermittent system of water supply where the pipe remains empty for long period, sterilization  of water cab be done in a number of ways. One of most commonly used system is to add chlorine  in the water supplied. This type of sterilization of water is called chlorination of water.  Chlorine is available in solid, liquid and gaseous form in solid form it is available in bleaching  powder and chlorine tablets.

When the chlorine is added to water, the following recttions  take place

 Cl2 + h2o = Hcl + Hoel Hocl  ____ H+ocl.

In this chemical reaction nascent fly drogen is formed which get evaporated. Also HOcl  (Hypochlorous acid) and ocl (Hypochlorite ions) are formed which are responsible for  disinfection. They destroy all the bacteria and help in oxidizing matter and ammonia cal  substance present in the water.

 When there is epidemic in the area and the residual chlorine drops suddenly. A high dose  chlorination is done( 0.50 to 2.0 ppm) depending upon the impurities this term is called super  chlorination.

Assuming effacing 80%

BHP= 10/0.80=12.5Hp

Q. 13.(a)  What precautions should be taken while casting of sunshades in a building to obtain  dense concrete of desired strength?

Ans  13(a):  General  sunshades  are  a  structurally  weak  link  in  a  building  and  very  first  collapse   during earth quakes.

1. Adequate cover to reinforcement should be ensured.
2. Shuttering should be of sufficient strength to with stand vibration compaction.
3. Compaction of concrete should invariably be done by vibrator.
4. Adequate water cement ratio and proper mixing of concrete should be ensured.
5. Top slope should drain out rain water immediately without ant stagnation.

(b)  What precautions  should be taken to avoid foul smells and seepage in toilet blocks of
buildings?.
Ans  13(b):  Toilets  blocks  of  building  are  observed  to  have  seepage  of  water,  peeling  of  plaster   and paint and foul smells.

1. All joints in plumbing work should made water tight.

2. Proper trap should be used with WC to provide sufficient water seal. This will keep away  foul smells.

3. Adequate  ventilation  and  sunlight  should  be  planned  by  providing  required  ventilators   and exhaust fans.

4. Good  quality  toilets  fittings  which  do  not  spill  water  help  keep  the  toilet  clean,  dry  and   free from bad smell.

5. Floors should have correct slope and floor traps and drain pipes should be kept clean to  carry discharge of Urinal pots and wash basins.

Q.No.14 Explain the method of construction of a subway by box pushing technique.

Ans- Box Pushing Technique, is the technique of construction of subway/under bridge,  by  which  precast  box  segments  of  bridge  are  pushed  under  the  track  without  disturbing  the   existing Railway / Road embankment by deploying adequate nos. of jacks. During execution of  work by this method railway traffic is allowed to pass at restricted speed. In this method a thrust  bed of suitable length is cast and thereafter R.C.C. Boxes segments are cast on thrust bed. These  boxes  are  pushed  through  the  Railway  embankments  by  Jacking.    The  required  thrust  is   generated through thrust bed. This method may be called safest method of crossing underground  / Embankment, without disturbing overhead traffic /Structures for R.U.B.   Steps involved in construction of Subway by box pushing technique.

1. Soil investigation.

2. Design of thrust bed and RCC box.

3. Excavation work and construction of thrust bed.

4. Provision  of  drag  sheet  to  reduce  frictional  forces  acting  on  box  during  pushing  and   thereby minimizes jacking effort and track disturbances.

5. Construction of precast boxes of suitable length on thrust bed.

6. Provision of cutting edge on front box and intermediate guiding shield on other  intermediate boxes.

7. Preparation  for  pushing    i.e.  Isolation  of  affected  length  of  track  from  LWR  and   imposition  of speed restriction, arrangement  of all necessary tools plants ,materials and   labours  for  pushing  work.  CRS  sanction  should  also  be  obtained  before  starting  the   pushing work.

8. Starting  of  pushing  work  and  maintenance  of  track  during  pushing.  Record  of  pushing   shall be maintained in pushing register.

9. Welding  of  track  after  completion  of  pushing  and  gradual  raising  of  Speed  as  per   IRPWM.  Approaches  of  bridge  to  be  watched  during  monsoon  and  track  should  be  frequently      attended on both side approaches due to settlement of earth.

Box Pushing Operation

•  To  push  precast  box  segment,  reaction  is  obtained  from  thrust  bed.  For  this,  screed  is   dismantled at pin pocket location, pin pockets are cleaned, pins are inserted and hydraulic Jacks-  8/10 nos. are installed between pins and bottom slab of the box with packing plates and spacers.

•  A  20mm  thick  plate  is  provided,  butting  against  bottom  slab  of  box,  in  front  of  the  Jacks  to  avoid  damage  to  concrete  surface  and  uniform  pressure  is  applied  to  the  jacksthrough  Power   Pack.

•  After  complete  push  (maximum  300mm)  jacks  are  released,  and  jacks  again  packed  with
packing plates and spacers. Process is repeated till front box is pushed to required position.

• Then 2nd box segment is slewed and brought in position behind 1st box segment.

•  Suitable  nos.  Jacks,  each of  200  Tons  capacity,  are  housed  between  two  box  segments  in   addition to Jacks already provided between thrust bed and 2nd box segment.

• 3  nos.  Jacks,  each  of  100  Tons  capacity,  are  provided  in  3  slots  made  in  each  side  walls  to
facilitate correction of line and level of box during pushing.

• Earthwork is now done in front of 1st box segment and it is pushed.

• Thereafter, jacks housed between two box segments are released and then 2nd box Segment is
pushed.

• Process is repeated till both the box segments are pushed to required position.

• Cutting Edge is dismantled & front face of 1st box segment is cast in plumb.

Precautions

1. Pushing  shall  be  done  only  in  presence  of  competent  Railway  P  Way  and  works   Engineer, who shall be in touch by walky talky/mobile phone.

2. At least 3 nos. Walkie -Talkie sets to be provided at site for effective communication  between Power Pack Operator, SE/Works and SE/P.way.

3.  Adequate work force inside the box for earth cutting and on the track for  maintenance should be available before starting the pushing.

4. Proper protection of track should be done before starting the pushing.

5. No pushing should be done during passing of train. Pushing should be done in  day
hours.

6. Train shall be allowed to pass only after correcting the disturbed track by P way staff.

7. Earth cutting should not be done beyond the tip of top cutting edge (i.e. tip of cutting
edge must always remain buried in earth) to avoid collapsing of earth.

8. Soil nailing should be done in case of sandy and cohesion less soil in the  embankment.

9. Safety equipment such as safety belts, helmets, reflective jackets  should be provided  to the workers

10. After  closing  of  the  day’s  work  earth  cut  embankment  should  be  supported  by   providing  earth  filled  bags  to  prevent  any  chance  of  collapsing  of  earth  due  to
movement of trains.

11. All consumables such as hydraulic oil and spare parts of jack pipes fittings should be  kept available at site.

12. Adequate  nos.  of  jacks,  based  on  weight  of  box  and  loading  capacity  of  jack  should   be utilized for pushing work.

13. Constant  watch  should  be  kept  on  the  pressure  gauge  of  power  pack  during  pushing   and it should be ensured that pushing should be stopped when pressure gauge shows the reading near 80% of the max pressure, to avoid busting of pipe and fittings.

14. Additional  jacks  should  be  provided  in  wall  and  roof  to  correct  the  horizontal  and   vertical misalignment of the box.

15. Level  and  alignment  of  the  box  should  be  checked  frequently  with  the  help  of   dumpy/auto level and theodolite.

Q.No.15 what precaution is to be taken during construction of LHS by cut and cover  method?  LHS may be constructed at level crossings having following conditions:-

I) Accident prone LC’s where visibility is not clear
II) Where embankment height is 3 meter or more.
III) Where ground water level is not high.

Steps involved in execution: -

1. Soil investigation of the proposed LHS site.
2. Casting of box as per approved RDSO drawing.
3. Casting of slabs as per approved drawing.
4. Obtaining CRS sanction if manned level crossing is involved.
5. Imposing speed restriction of 20 KMPH one day prior to traffic block.
6. Placing the box segments under track in mega traffic block.
7. Normalization of speed restriction. Approaches  of  LHS  should  be  kept  under  observation  during  monsoon  and  frequent  attention   would be required due to settlement of earth in approaches.

    Tools and equipment required at site:-

I) 150 MT capacity crane    - 02 Nos. +01 No standby

II) Poklain      - 02 Nos. +01 No. standby

III) JCB      -  02 Nos.

IV) Tippers      - 02 Nos.

V) Water Tanker    - 01 Nos.

VI) Gas Cutting and welding set  - 01 Nos. Sufficient manpower is also required for track and Works by the agency to execute the work.

Pre block activities

I) Demarcation at site: - Demarcation at site of proposed LHS is done and points  for cutting of track are marked with paint taking side slope into account.

II) Imposition of speed restriction and cutting of track rails: - Rail cut is made in  track after imposition of speed restriction and 1 mtr fish plate is provided on all  four joints.

III) Placing  the  precast  box  segments  and  slabs  as  near  as  possible  to  the   proposed alignment with the help of 150 MT capacity crane.

IV) Adequate qty of ballast may be procured to  make good the deficiency after  block.

During block activities

I)  Track  dismantling  and  removal  of  ballast:  -  As  soon  as  the  block  is   permitted the fish bolts of all the joints are opened and track is lifted with  the  help  of  crane  and  placed  at  suitable  place.  Ballast  is  removed  and  placed   within at suitable place so that it may be used at the time of restoration work.

II) Earth cutting: - Earth cutting will be done with the help of poklain from both  ends and JCB. A suitable side slope is maintained to suit the local condition of  earth.  After  completion  of  earth  cutting  up  to  desired  level  ,  Earth  surface  is   leveled and rammed to obtain uniform level.

III) Sand  filling:  -  Approx  150  mm  thick  layer  of  sand  is  provided  over  a  leveled   and compacted earth surface.

IV) Placing of slab: - Precast slabs are lifted with the help of crane and placed over  leveled  bed  of  sand  at  proper  alignment  of  LHS.  The  joints  of  slabs  are  filled   with cement sand mortors .

V) Box Placing:- The precast RCC boxes are placed over precast slab with the help  of crane in proper alignment.

VI)  Geo  membrane  and  Geo  textile:  -  Geo  membrane  is  pasted      at  the  joints  of   boxes to check the seepage of water through joints of boxes and  Geo Textile is  provided at the surface  exposed to earth and ballast to cover the top and side of  boxes  in  order  to  filter  the  water  during  rain  and  prevent  the  embankment  earth   from flowing with seepage water.

VII) Back filling: - Back filleting is done with machine to fill the space between side  of box and embankment across the track and get compacted simultaneously.

VIII) Ballast  Putting:  -  Ballast  putting  is  done  with  the  help  of  men  and  machine   available at site as per track profile.

IX) Track linking:-Track linking is done over spreaded ballast bed and then track is  linked with the existing track. Track is attended and all  parameters are checked  before allowing the traffic at restricted speed.

Break up tentative time taken in all during block activities is as under :-

I) Track dismantling & ballast removal - 25 minutes

II) Earth work in cutting - 60 minutes

III) Sand filling in Bed - 15 minutes

IV) Slab Placing - 30 minutes

V) Box placing - 90 minutes

VI) Geo Textile and Geo membrane - 20 minutes

VII) Back filling - 20 minutes

VIII) Ballast putting - 20 minutes

IX) Track linking and packing - 50 minutes

Total block required = 5 hrs and 30 minutes Precautions:-

1. Earth cutting to be done properly with proper slope and care should taken that side slope may not collapsed during block.

2. All engineers and workers should wear safety helmets before allowing them to work.

3. Sand bags should be provided on all four corners of the bank to retain and support the filled earth.

4. The entire Sling should be checked before starting the block and defective ones should be replaced.

5. After linking track should packed and XL and gauge should check before allowing first trains.

6. Standby crane should be placed at such location that it may be used in case of emergency without wasting much time.

Q.16. Design a column, square in section, to carry on axial load of 5000000N. Define bearing capacity of soil, explain different bearing capacity of soil, Explain plate load test of soil.

Provide 8 mm tie reinforcement at 380 mm centre to centre i.e. the least spacing among the three  criterias.

BEARING CAPACITY OF SOIL

1) Bearing capacity: The bearing capacity may be define s the ability of the soil to support  the load of the structural foundations without failure or deformation.

2) Ultimate bearing capacity: the maximum load intensity transmitted by the base of the  footing of a structure to the soil causing the soil mass to fail in shear, is defined as  ultimate bearing capacity.

3) Safe bearing capacity: the maximum load intensity the soil can take without any risk of  shear failure is called safe bearing capacity of soil. It is generally calculated by dividing  the ultimate capacity by a factor of a safety. Determination of ultimate bearing capacity of soil in the field To determine the ultimate bearing capacity of soil in the field ‘Plate loading test’ is normally  carried out. (IS: 1888-1962) Plate loading test: This is a simple test to determine the ultimate bearing capacity of soil in the  field.

1) The test essentially consist of rigid plate placed at the foundation on level. The ultimate  bearing capacity is determine by loading the plate till it starts sinking at a rapid rate.

2) The bearing plate is of square section of least 30 cm side and maximum 75 cm. the plate  should have sufficient thickness to withstand the anticipated maximum load and in no  case it should be less than 25 mm

3) The test pit width is kept five times the width of the plate. At the centre of the pit, a square hole of the size of the plate is made whose bottom is kept at the actual level of the fitting. The depth of the hole should be determine by the formula, Dp = D Bp B Apply a static load at the centre of the plate through a calibrated jack and the reaction is taken by a load truss.

Procedure: the following step are involved.

1. Place the plate in the hole, a seating load of 70 g/cm2 is to be applied before actual test is started.

2. Apply the load in convenient increment, one-fifth of the expected safe bearing capacity or one-tenth of the ultimate bearing capacity.

3. Observe the settlement with the help of two dial gauges fixed diametrically opposite each other, having the sensitivity of 0.02 mm.

4. Observe the settlement of each increment of load after an interval of 1,4,20,40 and 60 minutes and thereafter at hourly intervals until the rate of settlement becomes less than 0.02 mm per hour.

5. Now, apply the nest load increment till the maximum load that is applied corresponds to 1/1/2 times the estimated ultimate load or three times the proposed allowable bearing pressure.

Q. No. 17. As a AEN submit proposal for works programme 2016-2017 for construction of 100 type- II, 30 type-III and 10 type-IV quarters with justification, Abstract cost on forma chargeable Plan and covering letter addressed to Sr. DEN. (25)

Ans. The Preliminary Works Programme for the following year should be submitted by the Railways to the Railway Board by 1st week of September or such earlier date as may be laid down by the Board. Proper financial appraisal of each work should be given in the Preliminary Works Programme together with the comments of the financial adviser and Chief Accounts Officer.

The works should be arranged as per the Plan Heads. The items in the Works Programme should be grouped under the following categories while

compiling the Works Programmes :--

• (i) New Works.

• (ii) Works in Progress.

• (iii) Works approved in earlier years, which have not been actually commenced and on which no expenditure has been incurred till 30th June of the year previous to the Programme year.

• (iv) Works approved in the earlier years but estimates for which have not been sanctioned
The items in the Works Programme should be grouped under the following categories. Abstract estimate for construction of new staff qtr. In the section of ADEN/NR

Chargeable to Hand 53

Justification:- The fourth line work is in progress between JNC-PWL on TKD-PWL section and  expected to complete within two years. In connection with this many staff to be deputed in the  section. For this about 140 nos. staff qtr. Are to be required. Hence an estimate of Rs. 7.70 Crore  have been framed for inclusion in WP 2016-17 at an earliest please.

Forwarding Letter Sr. DEN-C  Subject: - Proposal for works programme 2016-17  A abstract estimate with justifications are herewith enclosed for sanction & further disposal  please.   DA/As above   ADEN/NR

Qus.  18.  What  is  the  disinfection  of  water?  What  are  the  precautions  to  be  taken  in   collection  and  transportation  of  water  sample?  When  in  a  water  sample  considered  to  be
chemically and bacteriologically satisfactory?

Ans:- The  disinfection of water has to be done to remove organisms that causes disease, before  entering  in to distribution system chlorination is used for disinfection of water.  The  water  should  be  collected  in  sterilized  gals  stopper  bottle.  There  should  be  no   external contact of mouth of the bottle the bottle should be filled to about 25mm below its neck ,  when sample of water is taken from a tab, the mouth of the tab should be heated by a sprit lamp  for 3 minute. Then water should flow for about five minute before sampling bottle is filled. The  bottle  should  be  properly  labelled  and  backed  and  should  be  sent  for  testing  without  delay.  A   sample  is  considered  chemically  satisfactory  when  the  PH  value  should  be  between  6.5  to   6.8,  Hardness between 300 to 600 mg/l calcium between 75 to 200 mg/l, Magnesium between 30 to  100  mg/l,  Dissolved  solid  between  500  to  2000  mg/l,  Chloride  between  250  to  1000  mg/l,   Sulphate  between  200  to  400  mg/l.  And  bacteriologically  satisfactory  when  coliform  is  Nil.   Water should be colour less and odour less.

Qus.20.  Design  of  a  water  supply  scheme  for  railway  colony  of  375  quarters.  In  addition  there  is  a  diesel  loco  shed  housing  85  locos  and  10  NOS  subordinate  offices.   Workout capacity of source, pumping and storage requirement. Assume data as required.

(B)   Yield  from  the  source  :-   In  summer  season,  the  source  should  be  able  to  supply  in  8
hrs the quantity of water normally required.         Yield of well, 60000/8=75000 lit/day

C. Pumping capacity requirement :-   The  pumping  system  should  be  able  to  supply  the  water  as  per  the  following   requirement

a.  Normal quantity of water requirement of 24 hrs in 12 hrs time or less 6.0 lac/12=50000 lit/hrs.

b.  Maximum   quantity  of  water  requirement  of  24  hrs  in  16  hrs  time  or  less

=  7,50000/16
=  45,312 lit /hrs C    Future  quantity  of  24  hrs  of  water  requirement  in  20  hrs  or  less
=11,25000/20=56250 lit   Taking maximum of the above 3 entries which is 56,250 lit.

Say 60000 lit per day   Requirement pumping capacity

 =60000 lit per hrs. And as such provide 1 service  pump and

No comments:

Post a Comment

Note: Only a member of this blog may post a comment.

Disclaimer: The Information/News/Video provided in this Platform has been collected from different sources. We Believe that “Knowledge Is Power” and our aim is to create general awareness among people and make them powerful through easily accessible Information. NOTE: We do not take any responsibility of authenticity of Information/News/Videos.

Index -

01. INTEGRATED CONCEPT AND OBJECTIVES OF MATERIALS MANAGEMENT (1) 01.02 रेलपथ निरक्षक तथा सहायक मंडल अभियंता के कर्तव्य (1) 02 रेलपथ (1) 02. ORGANIZATION OF MATERIALS MANAGEMENT DEPARTMENT (1) 02.01 90 यूटीएस रेलों के सम्भाल (1) 02.04 रेल तापमान (1) 02.05 रेल जोड (1) 03 स्लीपरो के कार्य (1) 03. CLASSIFICATION/CODIFICATION NOMENCLATURE OF STORES ON INDIAN RAILWAYS (1) 03.01 विभिन्न प्रकार के स्लीपरो की तुलना (1) 03.02 लचीले बंधन (1) 03.03 स्लीपर बिछाना (1) 04. PLANNING OF NON-STOCK ITEMS AND PROCESSING OF REQUISITION (1) 04.01 ट्रैक के लिए बैलास्ट प्रोफाइल (1) 04.02 फार्मेशन (1) 04.03 ब्रिज (पुल) (1) 05 पाइंट्स तथा क्रासिंग - परिचय एवं परिभाषाए (1) 05 PLANNING OF STOCK ITEMS & SYSTEMS OF RECOUPMENT (1) 05.01 विषेश ले आउट (1) 05.02 पृथक्रकरण (आइसोलेशन ) (1) 05.03 तथा क्रासिंग का अनुरक्षण तथा निरक्षण (1) 05.04 पॉइंट्स एवं क्रासिंग की (1) 06 गोलाई का प्ररंभिक ज्ञान (1) 06 PURCHASE POLICY (1) 06.01 वर्को का पुनः संरेखण (1) 07 Purchase Procedure on zonal Railways (1) 08 TENDER EVALUATION AND MISCELLANEOUS POLICY ISSUES IN PURCHASES (1) 08.01 व्यव्स्तिथ ओवरहालिंग (1) 08.02 रेलपथ अनुरक्षण का वार्षिक कार्यक्रम (1) 08.04 गहरी छनाई (1) 08.04.1 रेलपथ का उठाना लोवेरिंग तथा क्रीप (1) 08.05 छोटी वेल्डेड रेल ( एसडब्लूआर ) (1) 08.06 आन ट्रैक मशीन (1) 08.07 छोटी ट्रैक मशीने (1) 08.09 विद्युतीकृत सेक्शन में हाइट गेज (1) 08.11 अंडर ट्रायल सामग्री का रिकॉर्ड (1) 09 गति प्रतिबन्ध और संकेतक (1) 09 Receipt And Inspection of stores (1) 09.01 ठेकेदार की सुरक्षित कार्य प्रणाली (1) 09.03 रेल संरक्षा आयुक्त की स्वीकृति वाले कार्य (1) 10 निरक्षण का उद्देश्य (1) 10 ISSUE AND DISTRIBUTION OF STORES (1) 10.01 राइडिंग गुणवत्ता तथा राइडिंग इंडेक्स (1) 10.03 सिटीआर तथा टीजीआई (1) 10.04 रेलपथ प्रबंधन पध्दति (टीऍमएस ) (1) 11 RETURNED STORES (1) 11.01 स्लीपरो का बिछाना (1) 12 दुर्घटना (1) 12 Scrap Disposal (1) 12.01 ब्रीच (1) 12.02 डाईवर्शन (1) 13 INVENTORY MANAGEMENT (1) 14 लंबी वेल्डित रेल (परिभाषाए) (1) 14.01 एलडब्लूआर / सीडब्लूआरके लिये स्वीकृत स्थान (1) 14.02 एलडब्लूआरकी डीस्ट्रेसिंग (1) 14.03 एलडब्लूआर / सीडब्लूआर का अनुरक्षण (1) 14.04 रेलपथ पर्येवेक्षक - मेट तथा चाबीदार के लिए अनुमत तथा निषिद्ध कार्य (1) 15 - सर्वेक्षण (1) 15 बयाना राशि और जमानत राशि (1) 15.01 SURVEYING (2) 16 रेलवे टेंडर सिस्टम (Railway Tender System) (1) Accidents (2) Active & Passive Earth Pressure (1) Anti corrosive treatment (1) Ballast (2) Bearings in Bridge (1) Blanketing Material (1) Bridges (2) Buckling of track (1) Building Work (1) Cant deficiency & Cant Excess (1) Census (1) Chequered Tiles (1) Chlorination of Water (2) Chlorination Practices (1) Chlorine demand (1) Civil Engineering - Bridges (2) Civil Engineering - P Way (40) Civil Engineering - Works (5) CMS Crossing (1) Completion report (1) Contour & Contour interval (1) Correction Slip (1) CRS Sanction (1) CTR and TGI Value (1) Curing of Concrete (1) curves (2) Deep Screening (2) Design mode (1) Design of concrete mix (2) Destressing (1) Disinfection of water (1) disposal of human waste: (1) Distressed bridges (2) Distressing of LWR (2) distribution System (1) dry density (1) Duties (3) Duties & Responsibilities (9) Duties of Gateman (1) E01.02 Duties of Keyman / Mate / PWS (1) E02.01 Permanent Way (1) E02.02 Handling of 90 UTS rails (1) E02.05 Rail Temperature (1) E02.06 Rail Joints (1) E02.07 Maintenance of Rail Joints (1) E03.01 SLEEPERS AND FASTENINGS - Functions of Sleepers (1) E03.02 Comparison between Various Types of Sleepers (1) E03.04 Laying of Sleepers (1) E04.02 Ballast Profile for L.W.R. track (1) E04.04 Bridges (1) E05.01 Points & Crossings: Introduction & Definitions (1) E05.04 Maintenance and Inspection of Points and Crossing (1) E05.05 Reconditioning of Points and Crossing (1) E06.01 Basics of Curves (1) E06.02 Realignment of Curve (1) E08.01 MAINTENANCE OF TRACK-Through packing (1) E08.02 Systematic Overhauling (1) E08.03 Annual Programme for Regular Track Maintenances (1) E08.04 Lifting/ Lowering of Track and Creep (1) E08.05 Deep Screening (1) E08.06 Short Welded Rail (1) E08.07 Maintenance of SWR (1) E08.10 Level Crossing (1) E08.11 Equipments at Level Crossing (1) E08.12 Maintenance / Examination / Inspection of Level Crossing / Gate (1) E08.14 Welding of Rails (1) E08.15 Records of Material under Trial (As per Cs.no 99) (1) E09.01 Speed Restriction and Indicators (1) E09.02 Safe Working of Contractors (As per Cs.No 95) (1) E09.03 Works Requiring CRS Sanction (1) E10.01 INSPECTION OF TRACK - Object of Inspection (1) E10.02 Riding Quality and Riding Index (1) E10.03 Track Recording and Oscillograph Car (1) E10.04 CTR and TGI Value (1) E12.01 ACCIDENTS AND BREACHES - Accidents (1) E12.02 Breaches (1) E12.03 Diversion (1) E14.01 LONG WELDED RAIL - Definitions (1) E14.02 Permitted locations for LWR/CWR (1) E14.04 Maintenance of LWR / CWR (1) E14.05 DOs and Don’ts OF LWR For PWM / MATES & KEYMAN (1) Egineering (1) Elastic Fastening (1) Elastic Rail Clip (1) Encroachments of Railway land. (2) Engineering (26) Engineering - Book (3) Examination of Rails (2) Fabrication of Glued joint IN SITU. (1) Flushing cisterns (1) FOB (1) Gateman (2) Greasing of ERCs (1) Grow More Food Scheme (1) Guideline (3) H02 भण्डार विभाग का महत्व (1) H03 भण्डार डिपो की संरचना (1) H04 भण्डार का वर्गीकरण (1) H05 कोडिफीकेशन (1) H06 मानकीकरण एवं उसकी उपयोगिता (1) H07 वित्तीय औचित्य के सिध्दांत (1) H08 क्रय के विभिन्न माध्यम (1) H09 क्रय में विविध अधिमान्यताए (1) H10 भण्डार विभाग के अधिकारियो की क्रय शक्तियां (1) H12 निविदा समिति (1) H13 अनुबंध (1) H16 स्थानीय खरीद (1) H17 भण्डार डिपो में भण्डार प्राप्ति के स्त्रोत (1) H18 महत्वपूर्ण वस्तुए एवं उनकी खरीद (1) H19 भण्डार डिपो का संगठन एवं कार्य (1) H20 प्राप्ति अनुभाग की क्रिया - विधि (1) H21 वार्ड की क्रिया - विधि (1) H22 प्रेषण अनुभाग की क्रिया - विधि (1) H23 बहीखाता अनुभाग की क्रिया - विधि (1) H24 डिपो प्रणाली (1) H25 भण्डार का निरीक्षण (1) H26 अस्वीकृत भण्डार (1) H27 लौटाया गया भण्डार (1) H28 अग्रदाय भण्डार (1) H29 अधिशेष भण्डार (1) H30 रेल सामग्री की बिक्री (1) H31 रद्दी माल और नीलामी बिक्रिया (1) H32 वस्तु - सूची नियंत्रण (1) H33 स्टॉक सत्यापन (1) H34 मांगकरताओ व्दारा डिपुओ से भण्डार प्राप्त करने की प्रक्रिया (1) H35 संक्षिप्त टिप्पणीयां (1) Handling of 90 UTS Rails (1) Height Gauges on Electrified Section (1) Honey combing of concrete & its prevention (1) Hot Weather Patrolling (1) Imprest Store (1) INDEX (2) Indicator Boards & Signages (1) Inspection (6) Insulated joints (1) Isolation (1) Keyman / Mate / PWS (3) Laying of Sleepers (1) LDCE Exam (3) Level Crossing (2) Level crossings (2) Licensing Railway Land cultivation (1) Liner Biting (1) LWR (6) Maintenance (2) Maintenance in Electrified Area (2) Maintenance of CMS Xing (1) Maintenance of P Way (5) Maintenance of Rail Joints (1) Maintenancee of SWR (1) Manson precaution (1) Monsoon Patrolling (2) Numerical rating system (NRS) (1) Optimum moisture content (1) P Way (23) Pandrol Clip (1) pass (1) Patrolling of Rail Permanent Way (6) Permanent Way (2) Permanent Way (P Way) (10) Pile Foundation (1) Points and Crossing (3) Protection of Rail (1) Pumping Water Level (1) PWI (1) PWI / AEN / DEN (1) quality control (2) Question & Answer (62) Rail Clusters (1) Rail Formation (2) rail fracture (1) Rail Joints (1) Rail Renewal (3) Rail Welding (3) Rails Defects (2) Railway Affecting Works (1) Railway Construction (1) Railway Organisation (2) Realignments of Curve) (1) Reconditioning of Points and Crossing (1) Rehabilitation of Bridges (1) Renewal of Rail (1) River Training protection work (1) safe speed (1) Safe Working (1) Safety at P. Way Work Site (1) Schedule of Inspection of Bridges (1) Short Note - Bridge (8) Short Note - P Way (48) Short Note - Works (35) Short Notes - Mislanious (7) Sleeper (4) Sleeper Cribs (1) Soil Consistency (1) Special Layouts (2) Speed Restriction and Indicators (2) Static Water Level (1) Steel Structures (1) Stock sheet (1) Store (34) super elevation (1) Tender System (1) Testing of Rails (2) TGI and OMS (1) Thermit Welding (1) Through Parking (2) Tiles (2) Track Circuited Areas (2) Track Inspection (1) Track Machines (6) Track Management System (1) Track Tolerances (2) track-Overhauling (1) Transitions (1) Turnout (1) urinals (1) USFD (2) Venerable location (1) VIDEO (2) wash basin. (1) Washable Aprons (1) Water Cement ratio (1) Water closetsu (1) Water Quality (1) Water Supply (1) Waterproofing (1) weld failure (1) Well Foundation (1) Winter Precautions (1) Workability of Concrete (1) Working of Contractors (2) works (9) कार्य एवं उद्देश्य (1) ट्रैक रिकॉर्डिंग तथा दोलन लेखी कार (1) रेल पथ मेट के कर्तव्य (1)
